The base you already have, turned into standing ground.

SuperBase is not a pavement, and its primary mode is not a surface spray. It is an additive introduced into the base during the lay phase and carried through every moisture process, so the binder sits through the full depth of the layer rather than on top of it.

~75 mm

Existing base, scarified

Approximately. Additional roadbase is imported only where design levels require it.

Mixed through the full depth. Built, not coated.

The binder goes in with the water and is mixed through the whole layer, then wet rolled. Compaction develops the bond, so the surface strength comes from the layer itself.

Grader. Water cart. Roller. No pour.

A surface spray

Binder on top of the layer.

SuperBase

Binder and water mixed through the full depth of the layer, then wet rolled.

Cross-section of a yard base. A surface spray leaves the binder on top of the layer. SuperBase is mixed through the full scarified depth of around 75 millimetres.

How it is built

Five steps with ordinary plant, and no paving crew.

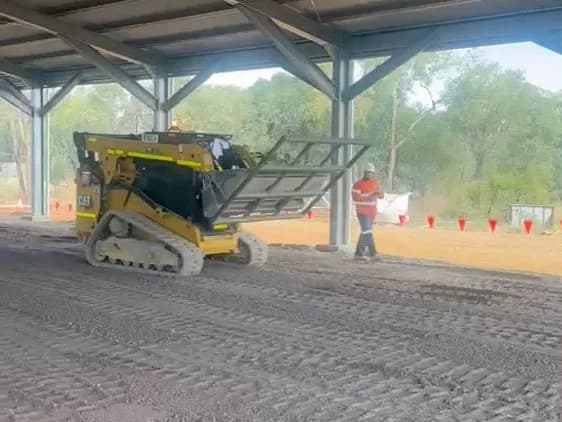

  1. Plant trimming and scarifying the existing yard base
    01 — Trimming the scarified base

    Prepare

    Loose stone and bull dust are graded off and the existing yard base is scarified to approximately 75 mm. Additional roadbase is imported only where design levels require it. Usually the material already in the yard is all that is needed.

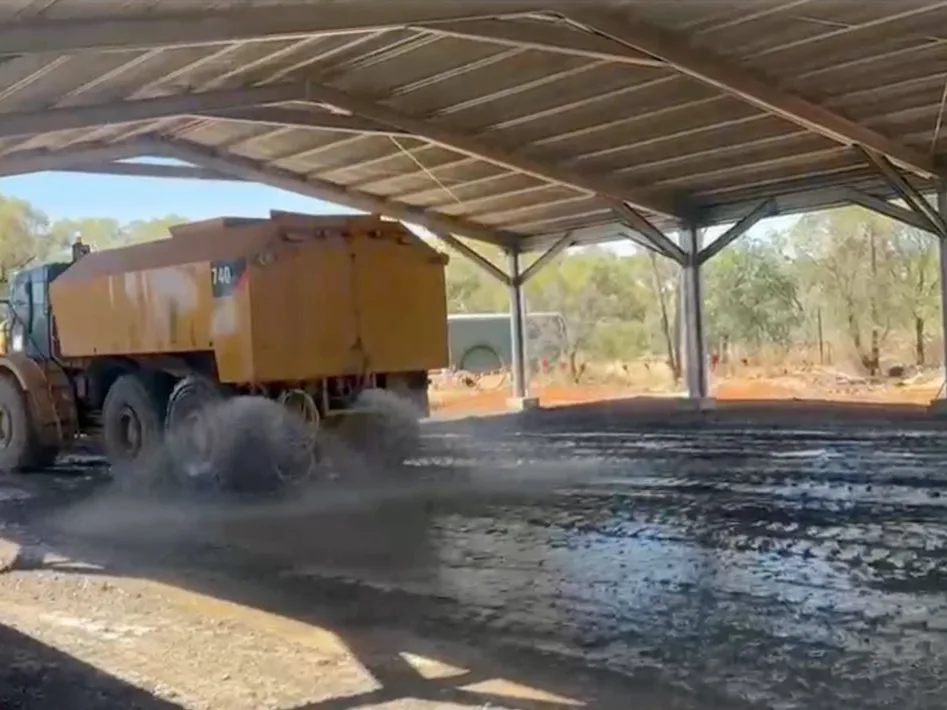

  2. A water cart spraying binder and water across the scarified base
    02 — Binder and water through the full depth

    Dose and mix

    SuperBase is introduced with water at a binder-to-water ratio set against your own base material, and mixed through the full depth of the layer. Where new base has been added, the binder runs through all moisture processes so the new layer does not delaminate from the old.

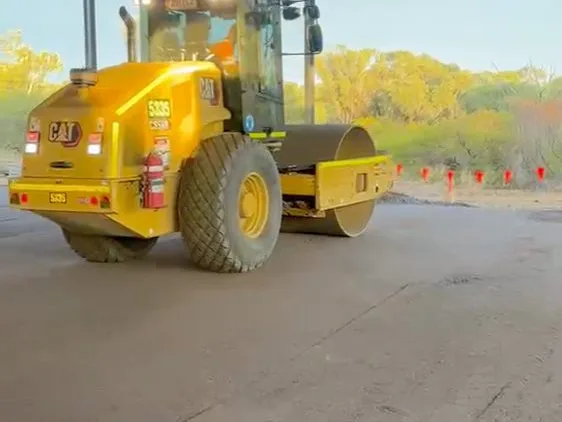

  3. The treated base being trimmed to level and crossfall
    03 — Trimmed to level and crossfall

    Grade to level

    The treated base is trimmed to design level and crossfall while it is still workable. Getting fall right at this stage is what stops water ponding later, and ponded water is where potholes start.

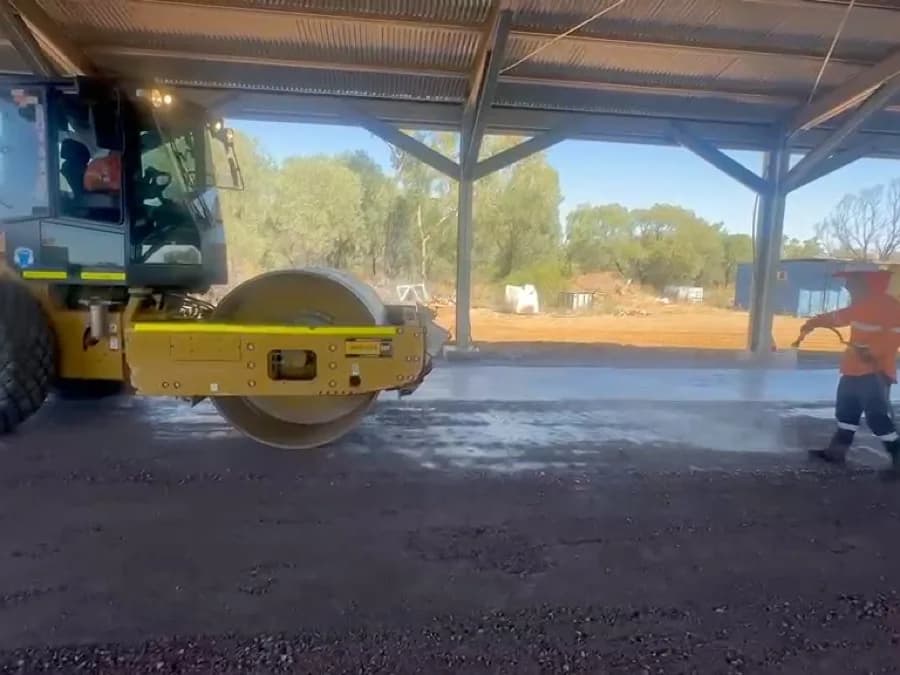

  4. A smooth drum roller wet rolling the base to final compaction
    04 — Wet rolling to final compaction

    Roll and compact

    Wet rolling to final compaction with a smooth drum roller. This is the stage that develops the bond: the surface is built, not coated, and it is where the surface strength comes from. Compaction is confirmed on site against the density nominated in the dosage design.

  5. A finished, bound surface back in service
    05 — Cured and back in service

    Cure and return to service

    The surface cures to a bound, hard-wearing hardstand and is trafficable within hours of the final roll, against the weeks a concrete pad needs to reach working strength. High-wear running lines can take an organic top coat, a sprayed dressing over the compacted base.

Compaction builds the bond. Testing proves it.

The strength gain is measured, not asserted. The trial area is tested by laboratory CBR on your own yard material, before treatment and after cure, and the result is issued with the trial report: a documented figure rather than a brochure claim.

What the trial report gives you

Soaked CBR
Before treatment and after cure, on your own yard material. Tested soaked, because that is the condition a yard fails in.
Depth & compaction
The treated depth and the density achieved across the trial area, measured on site.
Dosage rate
The binder rate that produced the result, so roll-out is priced and specified off a known number.
A laboratory CBR test on a compacted base sample
Soaked CBR, before and after

Nominate one area.

We will treat it, test it, and put the numbers beside a concrete quote and a year of patching.

A trial area tests the surface, the strength figure and the business case at the same time, on your material, in your yard.

One marked-out trial area of bound surface within an untreated yard
02 — Trial area
